Using 4D Scheduling for Reporting and Visualizing Schedule Delays and Status for Project Stakeholders

Using 4D Scheduling for Reporting and Visualizing Schedule Delays and Status for Project Stakeholders

The concept of 4D scheduling had been available for capital construction projects for more than a decade, nevertheless, even nowadays the use of 4D scheduling is mainly intended to be used by professional planners or at least for stakeholders who knows how to run those software applications as well as who are willing to pay for the investment associated in having access to such solutions.

On the other hand, there are many other project stakeholders, executives, and non-executives, who are keen to use the principle of 4D Scheduling to better understand and visualize the progress achieved on the project, compare planned with actual progress as well as have a better understanding of delayed activities. Most of those stakeholders neither have the knowledge and skills that planning and scheduling engineers have nor they want to learn how to use or invest in acquiring the software applications needed for this 4D Schedule analysis. Nevertheless, the one thing that they will not comprise on is that the 4D Schedule reporting needs to be based on trustworthy and traceable data sources. In addition, those stakeholders will not accept raw 4D schedules that are not accompanied by an explanation of what is being shared and presented to them.

The proposed 4D Schedule Delay Analysis Report as well as all other 4D Schedule Analysis reports will be developed using MS Power BI business intelligence and data visualization tool. The 3DBI visual developed by KG-DEV called 3DBI (https://kg-dev.be/) will be used to display the BIM model extracted from Autodesk Revit in MS Power BI. To ensure that the project schedule activities are associated with their relevant BIM object or asset, a field for the project schedule activity ID will be added as one of the data fields in the Revit data tables. The project schedule data along with the narrative for the delay and delays responsibilities will be captured from PMWeb which is the Project Management Information System (PMIS) used for this 4D Schedule Analysis report.

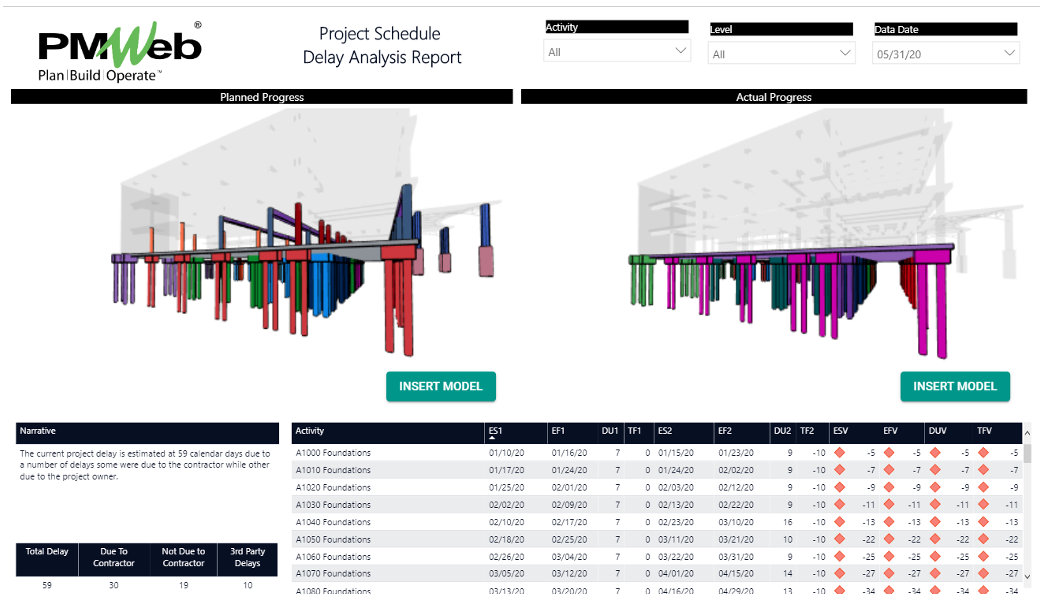

PMWeb 7 Project Schedule Delay Analysis Report

PMWeb comes ready with it is own scheduling module which enables not only creating the project schedules but also capturing all project schedule updates as well as the baseline schedule and all schedule revisions from third-party tools like Primavera P6 and MS Project. This data will become the basis for the project schedule data that will be used in the 4D schedule reports which will be extracted directly by MS Power BI. Capturing the project schedules data using PMWeb will ensure the project stakeholders who will be receiving the 4D schedule reports or any other schedule reports that the baseline, updated or even revised schedules were formally submitted, reviewed, and approved before they are shared with the project stakeholders.

Actually, one of the many default reports available in the PMWeb schedule module is the “Claim Analysis Report” which provides an example of the information that could be needed to be reported on in the “Project 4D Schedule Analysis Report”. The report allows comparing any two project schedule versions stored in PMWeb. The “Claim Analysis Report” report is designed to display the planned early start and early finish dates, planned duration and planned total float values, actual or current early start and early finish dates, actual or current duration, and total float values. The report will also report on the variance between the planned and actual or current early start, early finish, duration, and total float information.

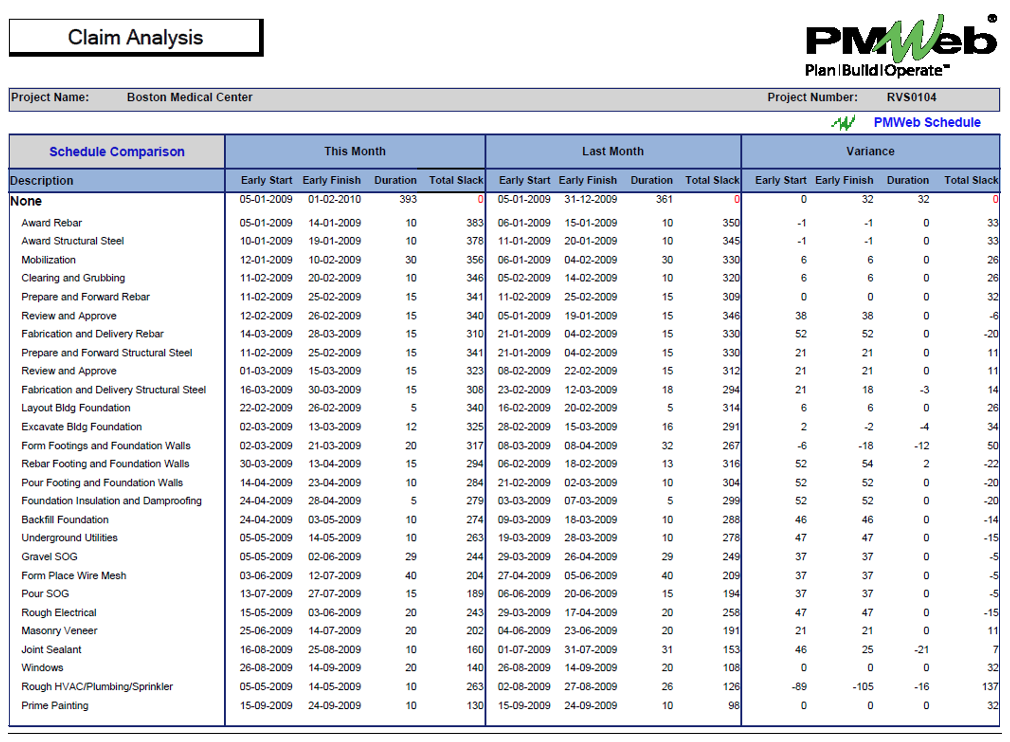

PMWeb 7 Claim Analysis

P PMWeb will be also used to create the input form for the narrative text that will be part of the 4D Schedule Analysis reports and for which it needs to be completed by the planning and scheduling engineer who is responsible for analyzing and reporting on project delays. The content of this form can be configured to include all fields that could be needed for the reports, nevertheless, as a minimum, it should include the progress period data date, contractor name, narrative text, total schedule delays to date, delays due to the contractor, delays that are not due to the contractor and delays due to third parties and neither the contractor nor the project owner or his/her authorized representatives. In case there is a need to share the report in languages other than English, then the form should include a field for capturing the narrative is the other language which could be for example Arabic.

The 4D Schedule Analysis Narrative Report will be created using PMWeb visual form builder where it will include all those fields. The form needs also to be attached with all supportive documents including the updated schedule reports and any other documents that need to be shared to verify the content of what is being reported.

In addition, a workflow will be assigned to the form to ensure the formalization of the submit, review, and approve tasks. The workflow will map those tasks along with the duration assigned each as well as the project team member responsible for performing the task. This will ensure the trustworthiness and traceability of the reported information.

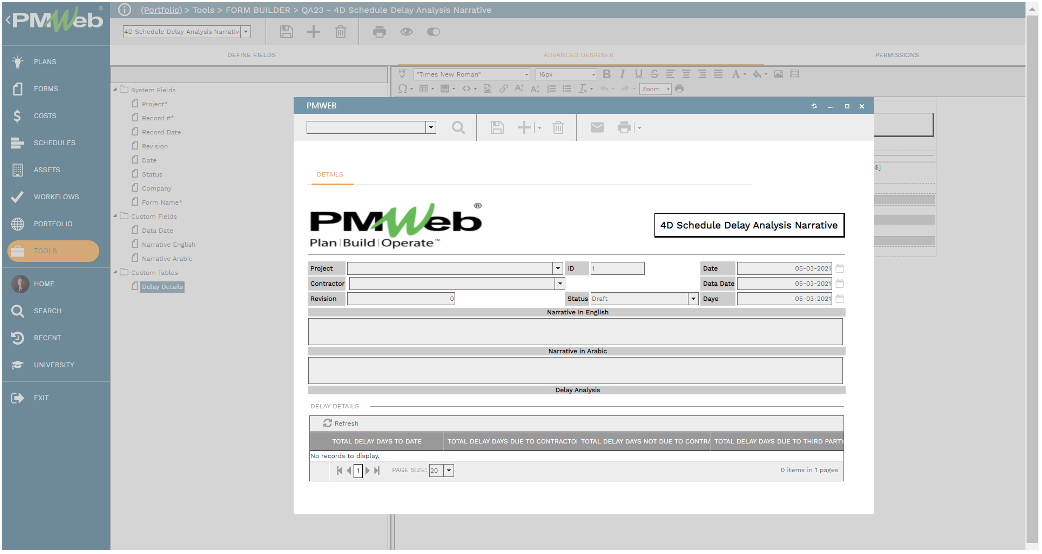

PMWeb 7 Tools Form Builder Schedule Delay Analysis Narrative PMWeb

The data captured in PMWeb will be used to update the information displayed in the 4D Schedule Analysis report as new schedule data becomes available at the end of each progress period. In addition, the report reader can select specific activities to be viewed in the report or by selecting the values of any other attribute defined in the report. In addition, selecting a BIM object from the BIM visual will automatically adjust the content of the report to reflect the data associated with the selected PMWeb object or asset.

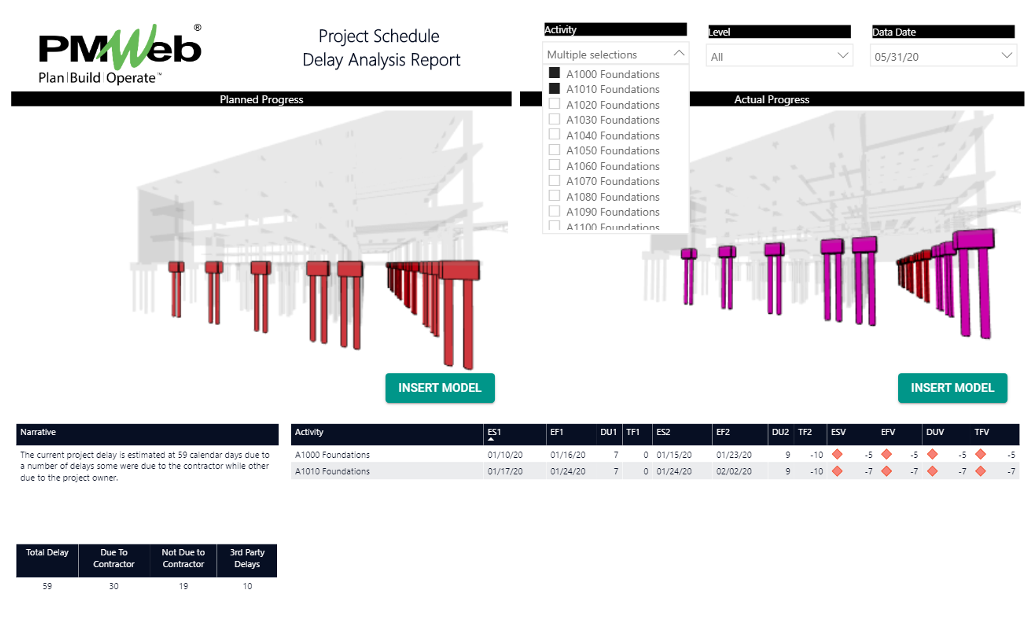

PMWeb 7 Project Schedule Delay Analysis

The proposed 4D Schedule Analysis report does not replace the need to have full 4D Scheduling that requires having dedicated software applications but they full a requirement by the stakeholder to have a better visualization of the project schedule information. The same approach of associating project management data with BIM models also adds great value to other processes like submittals, procurement, work inspection requests, testing and commissioning inspections and tests, punch lists, request for information, interim payment certificates among other project information captured in a Project Management Information System (PMIS) solution like PMWeb.
