Improving the Monitoring, Evaluating and Reporting the Performance of Long Lead Procurement Items on Capital Construction Projects

Improving the Monitoring, Evaluating and Reporting the Performance of Long Lead Procurement Items on Capital Construction Projects

For capital construction projects, long lead items are those construction components that will require a long time to obtain. In many cases, the long lead items will require the approval of shop drawings, or formal submittal approval, prior to ordering. The procurement of those long items can often have a significant impact on the project schedule as installation, construction and commissioning activities are heavily dependent on the delivery of these items.

Therefore, long lead items should be correctly identified at the start of the project and incorporated into the project schedule. The procurement activities of long-lead items should be periodically tracked to forecast any delays to the project’s milestone completion dates. The Long Lead Procurement is one of those reports that are commonly used on capital construction projects. The data for this report should be extracted from the purchase orders issued for the long lead procurement items which will be associated with it is relevant to project schedule activity.

The majority of long-lead procurement items are usually manufactured and shipped from different countries to the country where the capital construction project is being executed. Those items could be shipped by Sea, Land, or Air depending on the most economical and practical method to ship those items. Nevertheless, the planned shipping method could be changed for delayed items and for which the delivery duration needs to be accelerated.

The traditional reporting of the status of long-lead procurement items might be somehow ambiguous for some stakeholders. Therefore, including a map that will detail the shipping location for those items along with the option to select procurement items by the package or system they belong to, country of origin and procurement status will be required, and shipping method. In addition, the report can be used to report on the status of procurement items across the complete projects portfolio that the entity has.Using Project Management Information System (PMIS) like PMWeb as the trusted platform to manage the business processes for capital construction projects which will include the project schedule and purchase orders for long-lead procurement items coupled with an interactive business intelligence and data visualization tool like MS Power BI this challenge can be addressed. With the many types of visuals that can be used in MS Power BI to visualize and analyze the project’s data captured in PMWeb, there will be a requirement to use the map visual “Icon Map” which is a custom visual that allows in showing the origin of all long lead procurement. This requires providing the geospatial points for the shipping origin and the destination which will be the project construction site. The colors of the connecting line can be selected to reflect the shipping method which could Sea, Land, or Air.

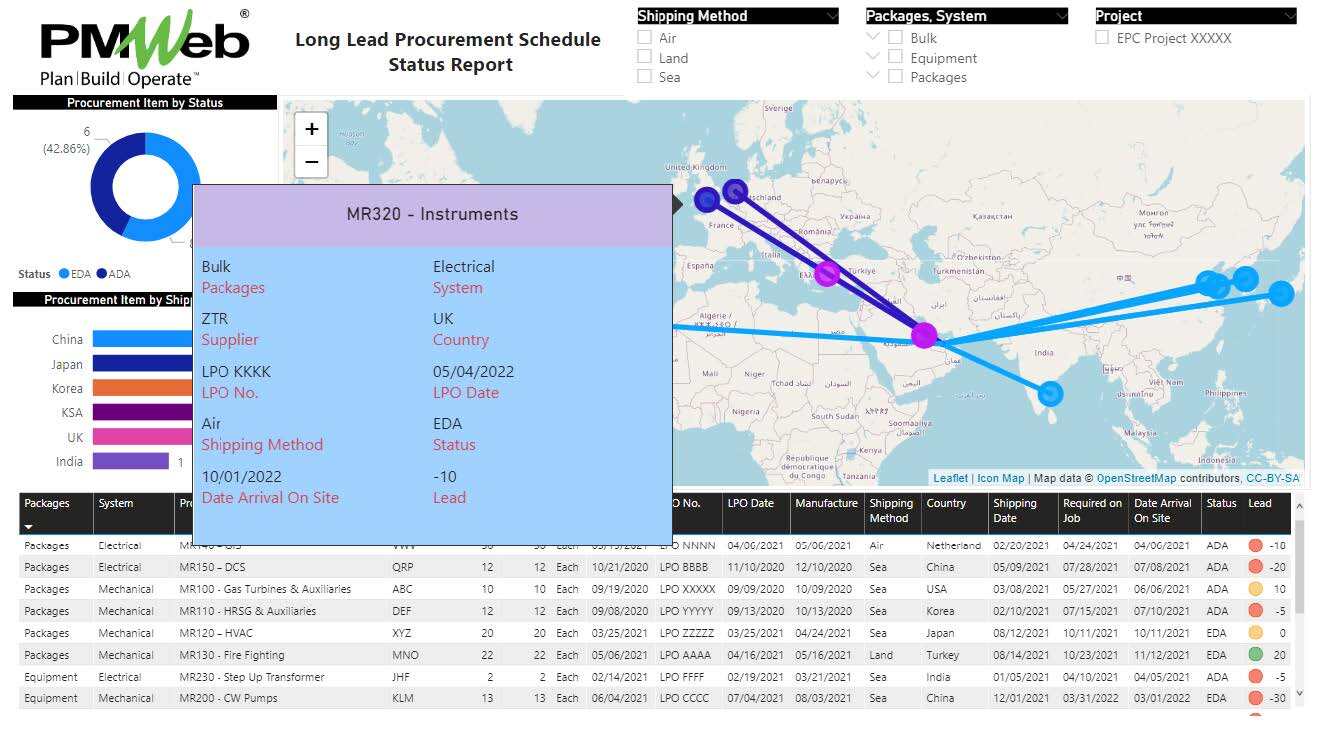

PMWeb 7 Long Lead Procurement Schedule Status Report

The reader of the Long Lead Procurement Schedule Status Report can drill down to any specific procurement item to have full details on its full shipment history status as well as other details that might not be captured at the status report. The report will include a map that will display the shipment status of the equipment on a map showing the current status, past shipment history, and planned route to the project site.

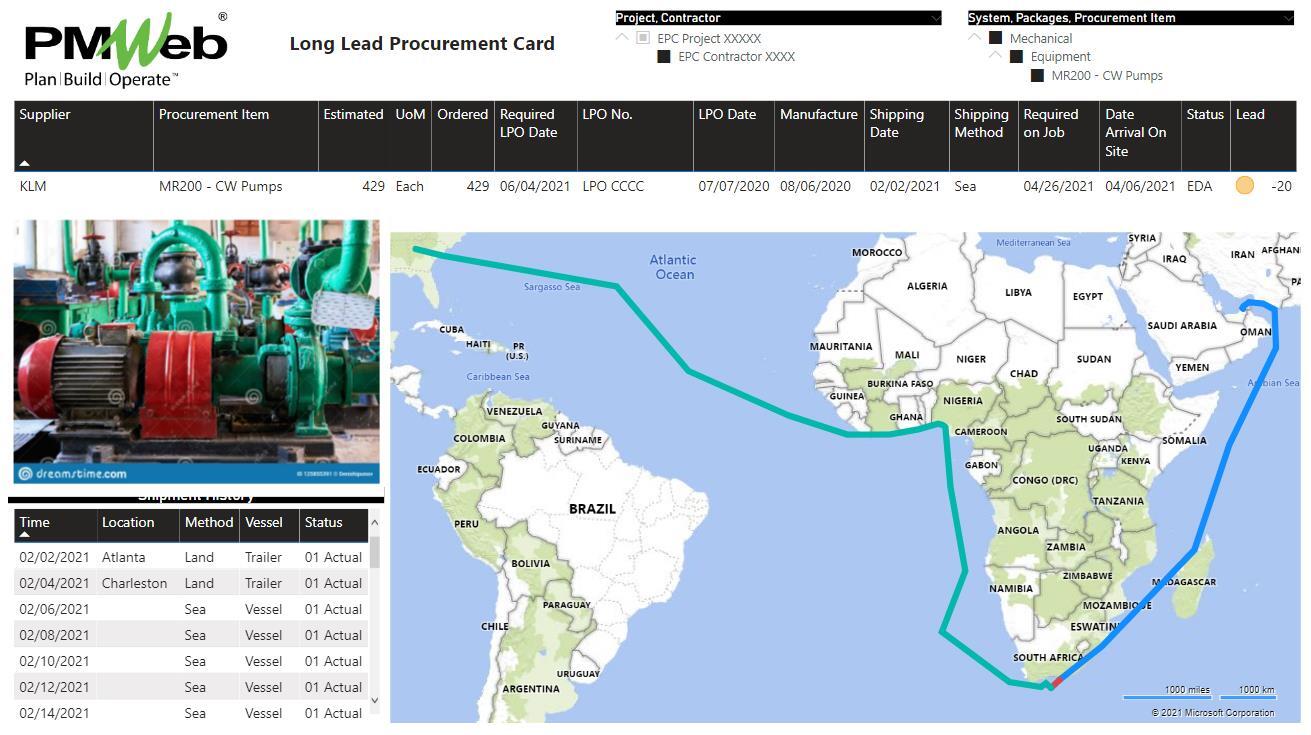

PMWeb 7 Long Lead Procurement Card

PMWeb commitment module which will be used to capture the details of all long lead procurement items purchase orders will be configured to include six additional user-defined fields. Those will be the fields for procurement group, building systems, and equipment type. In addition, there will two fields for the latitude and longitude fields of the shipment origin. The latitude and longitude fields for the destination or project construction will be defined on the project module. The last user-defined field is the project schedule activity that relates to the long lead procurement item. For purchase orders that include multiple long lead items, the project schedule activity field will be assigned at the item level. This will enable reporting on the procurement status of each item if this is required.

PMWeb 7 Costs Contracts Commitments Electrical Equipment
Main

To ensure that the long lead procurement schedule activities are current, the updated project schedule needs to be imported from either Primavera P6 or MSP unless the schedule was created in PMWeb. This will ensure that the date calculations for long-lead procurement items are accurate and up to date.

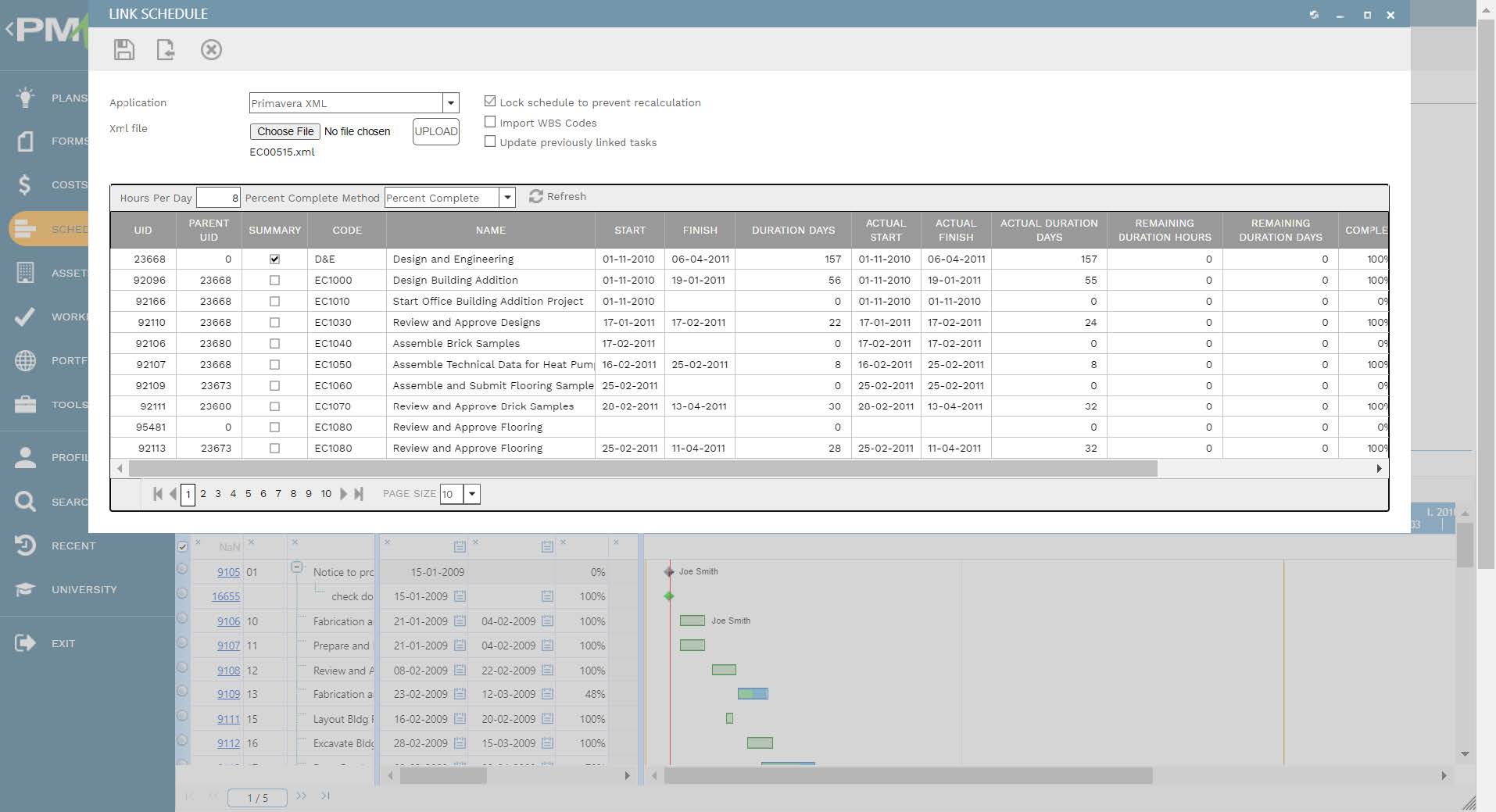

PMWeb 7 Link Schedule

PMWeb custom form builder will be used to create the template to capture the shipment history of each long lead procurement item. The template will include a table that will detail the latitude and longitude values for each date in the track report. Those dates will be classified as either Actual, Now, or Plan to identify the status of the shipment. Additional details can be added as the location name, method of shipment since an item might be shipped via Land or Rail before it gets shipped by Sea, and the vessel name. This data will be the data source used to plot the shipment route of each long lead procurement item.

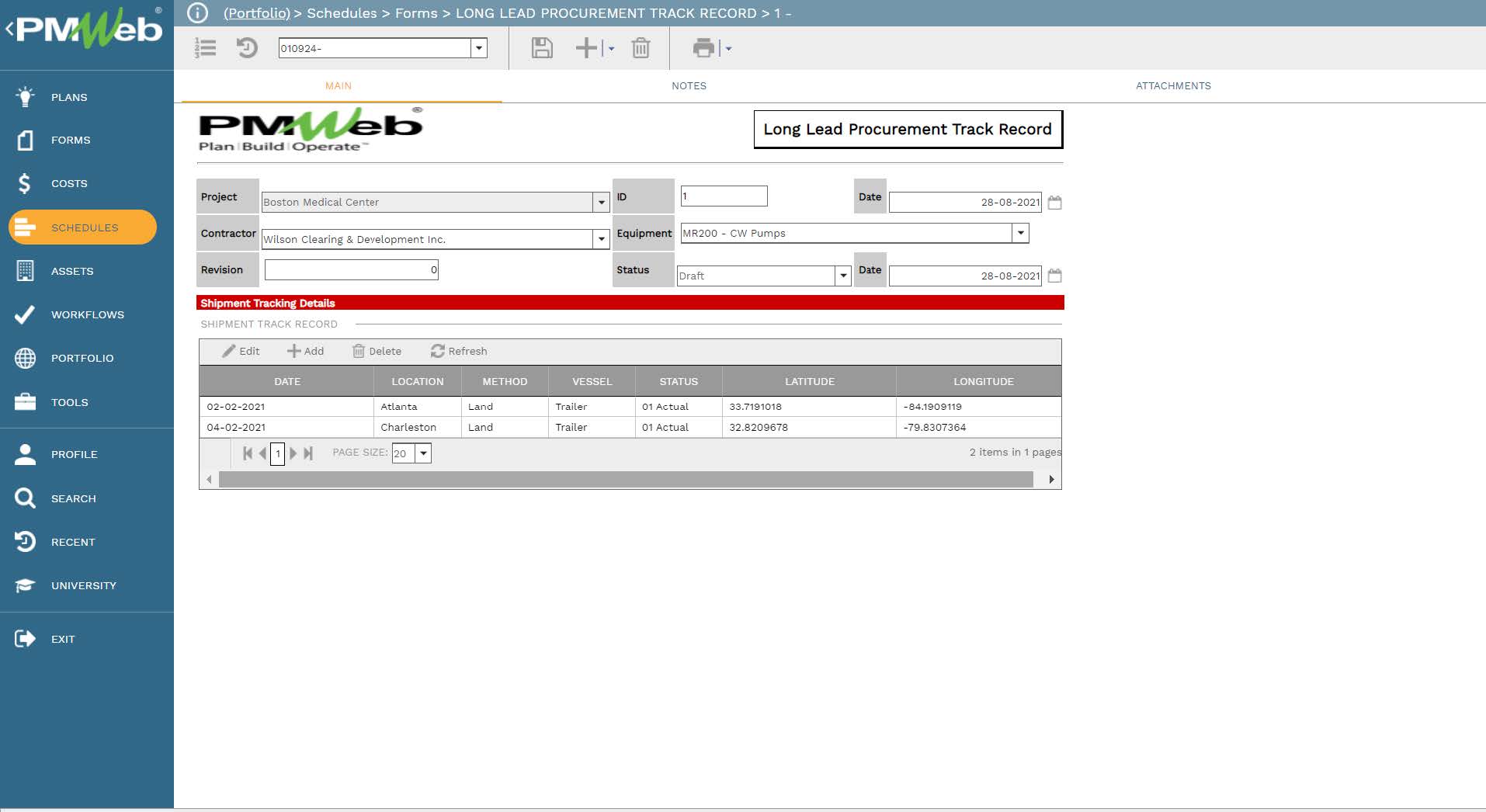

PMWeb 7 Schedules Forms Long Lead Procurement Track Record
Main

To provide complete transparency on the procurement of long-lead items, all supportive documents need to be attached to the purchase order as well as the shipment tracking report. Those documents could include copies of the original issued purchase order, factory-based test certificates, shipping documents, clearance documents, delivery notes, pictures of the long lead items among many others. PMWeb attachment tab in those templates will be used to attach all those supportive documents. It is also highly recommended to add comments to each attached document to provide a better understanding of what was the document for. The attachment tab also allows the user to link other records for business processes implemented in PMWeb as well as associate URL hyperlinks with websites or documents that are not stored in the PMWeb document management repository.

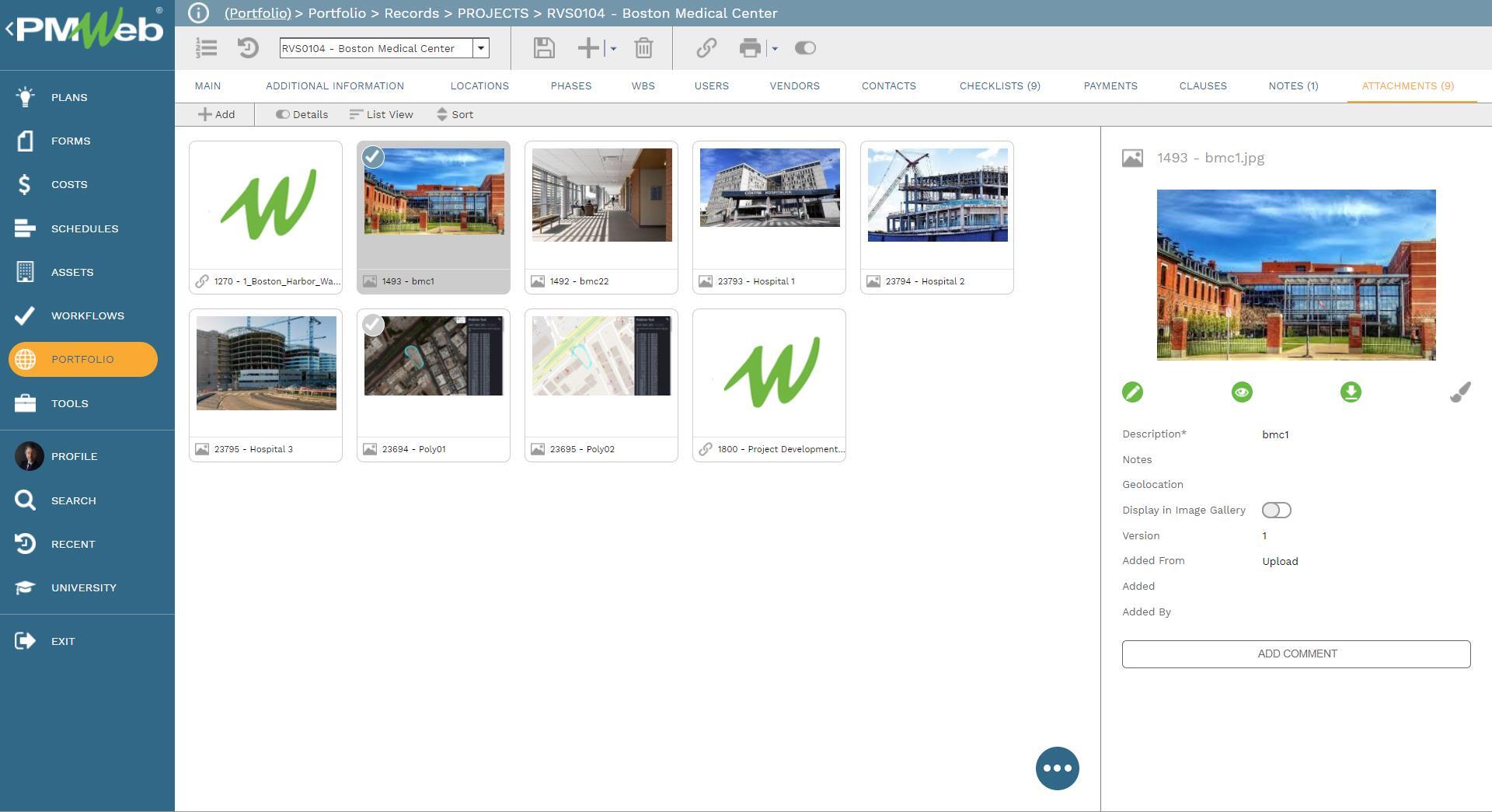

PMWeb 7 Portfolio Records Projects Boston Medical Center

All those supportive documents need also to be uploaded into the PMWeb document management repository so they can be stored and used. Those documents could be uploaded into folders or subfolders so they are better organized and secured. PMWeb allows setting access rights to each folder to identify the users who have access rights to view documents stored in a folder. In addition, PMWeb allows setting notifications for individuals to receive emails when new documents are uploaded or existing documents were downloaded or deleted.

PMWeb 7 Document Manager Projects Capital Project Construction Phase BP02 Superstructure
